Multiplex Development Hub · For developers

    Building a multiplex in Burnaby.

    Most of what has been written about SSMUH explains the zoning. This guide starts after that, at the point where you already know a lot is eligible and you need to know whether the project works: what it costs to build, how long it takes, and how much of your own money is tied up before the bank funds anything.

    Last reviewed August 2026

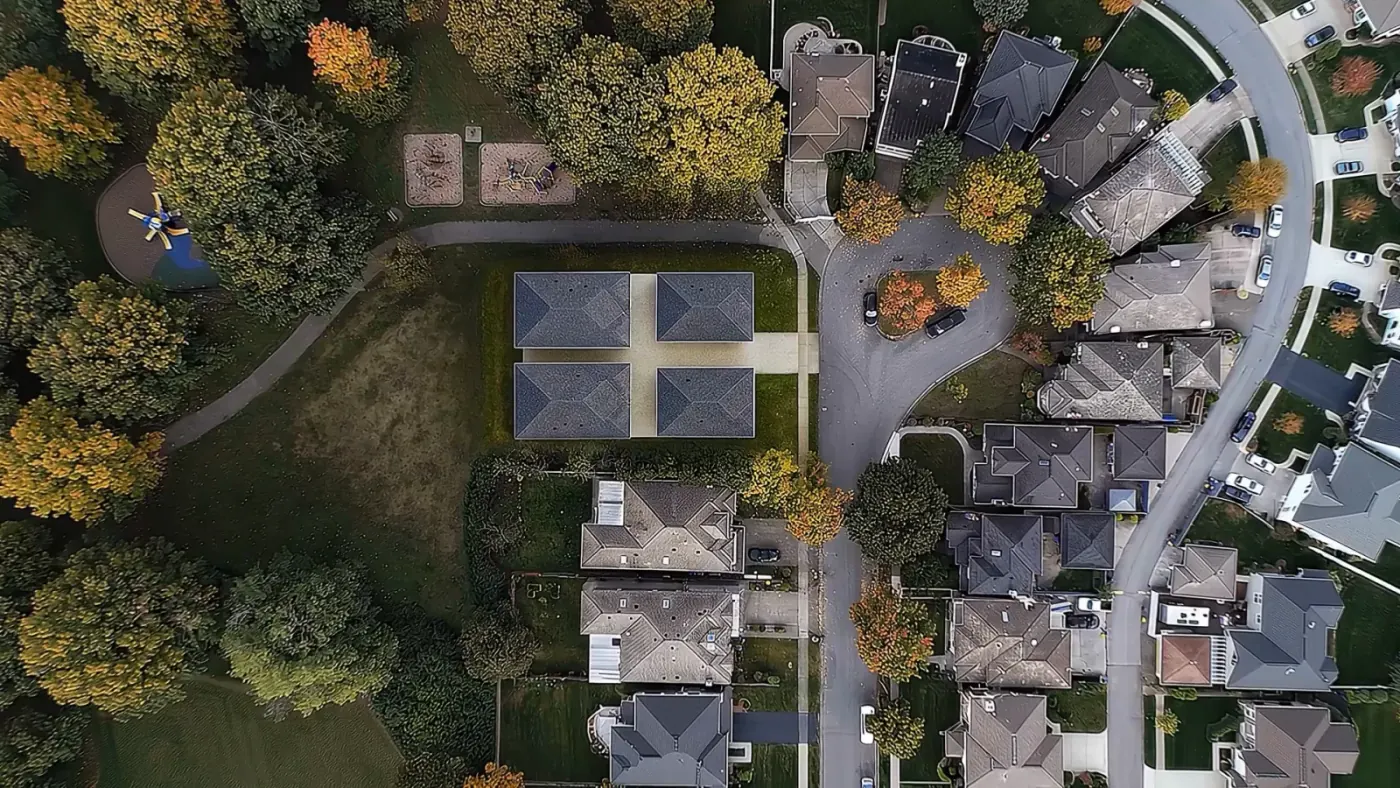

    Aerial drone view of 7609 Coldicutt in Burnaby, four detached strata homes arranged in two pairs on a single cul-de-sac lot beside a park, surrounded by single-family houses
    7609 Coldicutt, Burnaby. Four detached strata homes on one former single-family lot, built under R1 SSMUH zoning.

    Is it worth building a multiplex in Burnaby?

    A multiplex works on a Burnaby R1 lot when three things line up: the land price, the number of units the lot genuinely fits after setbacks and tree protection, and your build cost per square foot. The zoning permits 3 to 6 units, but permitted is not buildable, and the difference between four units and three is usually what decides whether a project is viable. Test the lot before you write an offer, not after. Run a fit test against the R1 envelope, confirm servicing capacity at the curb, and price the build against a real builder quote rather than a per-square-foot rule of thumb.

    If you have not confirmed the zoning question yet, start with our Burnaby R1 SSMUH guide or run the address through the lot eligibility tool. This hub assumes that part is settled.

    How to build a multiplex in Burnaby: the zoning and the permit steps

    Most Burnaby house lots can take a multiplex of 3 to 6 units with no rezoning. All lots from the City's 12 former residential districts are now in the R1 Small-Scale Multi-Unit Housing District, which allows 3 units on a lot up to 280 m², 4 units on a larger lot, and 6 units on a lot of at least 281 m² inside a Frequent Transit Network Area. Secondary suites count toward that total.

    A Frequent Transit Network Area is any lot wholly or partly within 400 m of a bus stop with service every 15 minutes on average, 7 am to 7 pm on weekdays and 10 am to 6 pm on weekends. BurnabyMap shows these areas under "Planning & Building". These are the R1 limits that shape a multiplex building:

    R1 ruleLimit
    Floor areaNo set limit. Height, setbacks and lot coverage set the size
    Front building height10 m above grade (0.5 m less with a flat roof), 3 storeys for 3 to 6 units, counting a basement or cellar
    Lot coverage40% for 1 to 4 units, 45% for 5 or 6 units
    Permeable area40% for 1 to 4 units, 30% for 5 or 6 units; half of it planted
    SetbacksFront 4 m, side street 3 m, lane 1.5 m, interior side 1.2 m, interior rear 3 m
    Smallest unitStudio 37 m², 1 bedroom 56 m², 2 bedrooms 90 m², 3 bedrooms 111 m², 4 or more 125 m²
    ParkingOutside a transit area, 1 space for the first unit and 0.5 for each one after; inside one, none

    The City has its own application for a multiplex, which it defines as a building with 3 or more primary units. The steps run in this order:

    1. Check the lot. On BurnabyMap, the maximum units per lot counts primary units and suites together. Look for easements, covenants, heritage status and any stream, ravine or wetland within 30 m, which needs a streamside assessment. An existing house needs a demolition permit with a waste diversion plan.
    2. Plan the site. Every multiplex gets a condition to keep space on the lot for a BC Hydro transformer, and the City asks you to contact BC Hydro before you apply. The drawings must show the trees you keep and plant, and where garbage and recycling are stored. Lots with 2 or more primary units can be stratified; a secondary suite stays on the title of the unit it sits in.
    3. Get Engineering pre-application approval. Projects with 4 or more primary units also follow the City's Servicing Improvements Guide. The City says complete submissions "typically take about 15 business days" to review.
    4. Apply for the multiplex building permit in the My Permits Portal. A building over 3 storeys above grade or over 600 m², or one with shared underground parking, uses a different application.
    5. Build, inspect, occupy. Development and amenity cost charges are collected when the permit is issued, or at subdivision where the City collects them then. Each inspection needs 24 hours' notice, and nobody moves in until the City issues the Occupancy Certificate.

    The full R1 rules for every housing type are in our guide to Burnaby R1 zoning and units per lot, and the time each stage takes is in how long it takes to build a multiplex.

    Sources: City of Burnaby, R1 SSMUH District summary (July 2026) and New Home Construction, both read 6 November 2026.

    The three questions that decide it

    Every developer who calls us about a Burnaby lot asks the same three questions, usually in this order. Each one has its own page.

    What actually fits on a Burnaby lot

    Unit counts get discussed in the abstract far more often than they get drawn. Below is the site plan for 7609 Coldicutt, the four-home detached-strata multiplex we are completing in Burnaby this fall. It is worth reading carefully, because it shows the constraint that decides most Burnaby projects: not the unit count the bylaw allows, but the width left over once you subtract the side setbacks and the pedestrian access every rear unit needs.

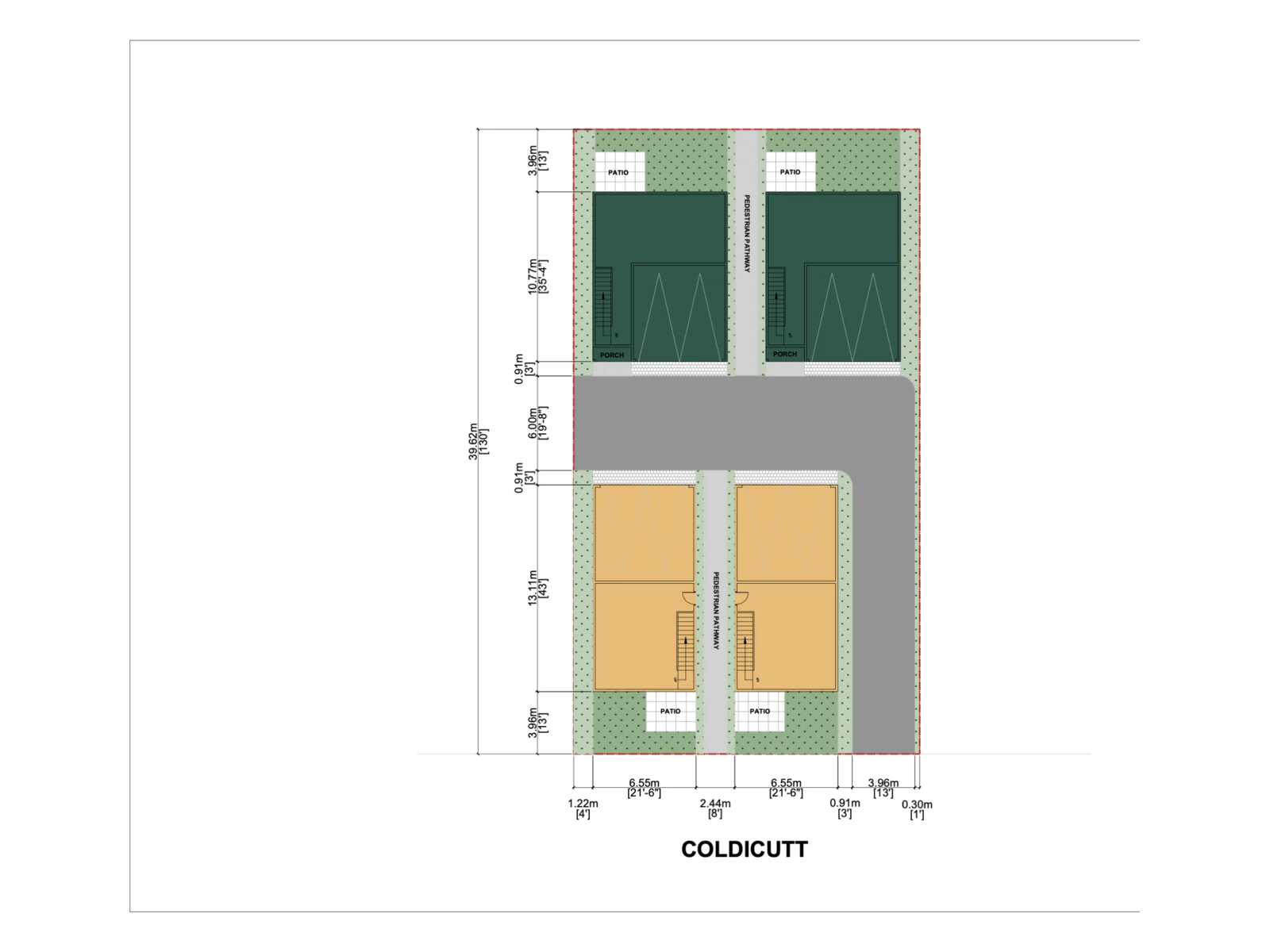

    Site plan drawing for 7609 Coldicutt in Burnaby showing four home footprints in two pairs, a central pedestrian pathway, patios, and dimensions including a 39.62 m lot depth and 6.55 m unit widths
    Site plan, 7609 Coldicutt. Dimensions as drawn: 39.62 m (130 ft) lot depth, 6.55 m (21 ft 6 in) home widths, a 2.44 m (8 ft) central pedestrian pathway, and a 6.00 m (19 ft 8 in) drive aisle.

    Two homes face the street and two face the park behind. Each keeps its own front door, garage and yard, which is what makes them saleable as houses rather than as units. The front pair sits 10.77 m (35 ft 4 in) deep, the rear pair 13.11 m (43 ft). The 2.44 m pathway down the middle is not wasted space, it is the legal access that makes the rear homes possible at all.

    The practical lesson: on a standard Burnaby lot, depth is usually available and width is not. When a lot cannot carry the width for two homes side by side, the plan changes shape entirely, and so does the cost per square foot. This is why we test the envelope before quoting anything.

    Why the builder matters more on a multiplex than on a house

    On a custom home, a builder who runs three weeks long costs the owner inconvenience. On a multiplex, the same three weeks cost interest on the construction loan, on the land, and on every dollar of equity sitting idle. Schedule is not a service quality issue in development, it is a line in the proforma.

    The same is true of cost certainty. A builder who wins the job on an optimistic number and recovers it through change orders has not saved you anything, they have moved your risk to a point in the project where you have no leverage left. What matters is whether the number holds.

    • Ask what happens to the schedule if an inspection fails. The answer tells you whether the builder has run multi-unit work before or is treating it as four houses at once.
    • Ask who carries cost between permit and lockup. On most projects the answer is you. It does not have to be, and that page explains how ours works.
    • Ask to see a multiplex they finished, not one they are starting. Anyone can show renders. Ask what the final cost was against the original contract.
    • Confirm the warranty registration. Every unit you intend to sell needs 2-5-10 coverage through a BC Housing licensed builder. Check the licence yourself on the BC Housing registry rather than taking it on trust.

    Our own credentials are listed on the credentials page, and the longer version of this argument, written for homeowners but equally applicable here, is in how to choose a builder.

    Run the numbers on a specific lot

    Two tools on this site do the first pass for you, both free and neither requiring a call with us first.

    Common questions

    Is a multiplex worth building on a Burnaby R1 lot?

    It depends on three numbers: what the lot costs, how many units it actually fits after setbacks and trees, and what you can build for per square foot. The zoning permits 3 to 6 units, but permitted is not the same as buildable. Run the lot through a fit test and a proforma before you write an offer.

    How many units can I get on a Burnaby lot?

    Under Burnaby's R1 SSMUH zoning, up to 3 units on a lot of 280 m² or less, up to 4 above that, and up to 6 on a lot of at least 281 m² that sits wholly or partly within 400 m of a bus stop with 15-minute service (a Frequent Transit Network Area). Secondary suites count toward the total. Site geometry, protected trees and servicing capacity routinely reduce what fits below the permitted maximum.

    Who builds multiplexes in Burnaby?

    Icon Projects builds multiplex and small-scale multi-unit housing across Burnaby and Greater Vancouver, from feasibility and rezoning through to occupancy. We are a CHBA Master Residential Builder and licensed by BC Housing under the 2-5-10 home warranty. Our current Burnaby multiplex, 7609 Coldicutt, completes in Fall 2026.

    What is the difference between a multiplex and a townhouse development?

    A multiplex under SSMUH is built on a single existing residential lot with no rezoning, using the units the zoning already permits. A townhouse development usually needs a rezoning or development permit, takes far longer to entitle, and carries a much heavier soft-cost load before a shovel goes in the ground.

    Can multiplex units be stratified and sold separately?

    Yes. Provincial legislation allows strata subdivision of SSMUH units, and Burnaby has been issuing strata-eligible R1 permits since the zone was adopted. The path is cleaner on attached forms than on several detached principal buildings on one parcel, so decide your exit early because it shapes the design.

    How much capital do I need before construction financing arrives?

    That gap, between buying the land and drawing on a construction loan, is where most small multiplex projects stall. It usually has to cover design, consultants, permits and early site work. Our vendor network carries most of that cost to lockup, which is the specific reason we can start projects other builders cannot.

    What is the fastest way to find out if a specific lot actually works?

    Run it through a lot fit test, checking setbacks, protected trees, servicing capacity and lane access against the R1 SSMUH rules, before writing an offer. Permitted unit count and buildable unit count are different numbers on most Burnaby lots, and the gap between them is what a fit test exists to find.

    Does a multiplex on a single lot need rezoning?

    No, that's the defining feature of SSMUH. It's built on a single existing residential lot using the unit count the zoning already permits, so it skips the rezoning and development-permit process a townhouse project usually needs. That's a large part of why the entitlement timeline is shorter and the soft-cost load is lighter.

    Related reading

    Developer enquiries

    Send us the address.

    If you are looking at a Burnaby lot, send us the address and we will tell you what we think fits on it and what it would cost to build. No obligation, and we will tell you if we think the project does not work.
